When the Metropolitan Theater—the MET to all of us—opened on December 10, 1931, it was a spectacular marriage between Paris and Manila. Influenced by the Art Deco movement which was set into motion during the Paris Exposition of 1925, the MET made use of Filipino designs by architect Juan Arellano and designers Arcadio Arellano and Isabelo Tampinco. When these giants put their heads together, they wanted to assert their own cultural independence from the US colonial era. This meant something done in a different vein from the neo-classical structures so prevalent at that time. This wouldn’t be another Legislative Building or Post Office. This wouldn’t be another structural symbol of US rule and ideology. It would marry a new movement with a native sensibility.
The MET façade has tall Angkor Wat-inspired minarets at the edge of curved walls. Four parapets boast Hindu-inspired bronze sculptures by Italian sculptor Riccardo Monti. Its front side walls – at left and right - have furling ferns and fire-like batik patterns that borrow from the region’s Muslim countries. The façade’s lower middle portion - a mini-arch with rows of small finials – frames a big rectangular stained-glass panel by Kraut Glass. Light comes into the lobby through the glass panel. Moldings and sponge-applied multi-colors decorate the walls. Wrought iron gates with leaf and bird of paradise motifs— done in the Art Deco style—festoon front and side entrances. Pavilions surrounding the building cover secret gardens that are seen from the lobby and the auditorium. We know it as the MET, but its other name is marvel.
The MET was initially refurbished with help from the Reparation Act of 1946 and the P1 million fund raised by the Metropolitan Theater Company after World War II. It was given a third life by former first lady Imelda Marcos with a P30 million loan from the Government Service Insurance System in 1978. The MET was opened four times: in 1931,1946, 1978, and 2010. It is now awaiting its fifth opening.
From its last renaissance to now, it’s fallen into disrepair and shady hands.
Architects, artists, and conservationists are now asking: When will Filipinos see the MET in all its former glory again?
A new form but the same old characters
The Philippine government’s P 266.77 million project to conserve Manila’s 88-year old Art Deco marvel has been plagued by delays and in-fighting—not to mention the slow implementation of proposed alterations, the firing of two sets of compliance-seeking professional consultants, and a possible re-organization that could relegate the National Commission on Culture and the Arts (NCCA)—the project’s sole funder—from a lead role to a mere management body.
“We are in the process of reviewing the project,” says NCCA chair Virgilio Almario. He heads NCCA’s nine-man powerful board which was created before the Met project began in 2017.
More stories on heritage structures:
“It’s Topsy-Turvy Here,” says NCCA Executive Director Rico Pableo
Bringing back the Met’s splendor for the third time, with NCCA’s loaded budget from the Endowment Fund for Culture and the Arts, could “go to waste without regulatory measures,” say the architects and engineers of NCCA’s six-man Professional Management Team (PMT). They were hired between 2017 and 2018, for check and balance measures, and to provide assistance to NCCA executive director Rico Pableo (who signs check payments). They were fired last February 15, 2019.
One of them, Architect Nino Mata—NCCA’s assistant construction manager starting Oct 2018 – requested Ombudsman Samuel Martires to investigate government officials for allegedly “manipulating, (and) conniving with the (Met’s) contractor.” This refers to the 401 Development and Construction Corporation, in joint venture with RR Encabo Construction Inc. It is alleged that the conservation project has been stalled due to contractor coddling and “alleged corruption.” So reads Mata’s two-page letter to the Ombudsman.
Requested for investigation were NCCA chair Almario, board member; Rev Fr. Harold Rentoria. board member and head of NCCA’s Sub-commission for Cultural Heritage; Jeremy Barns, board member and Director of the National Museum; Rene Escalante, board member and Chair of the National Historical Commission of the Philippines (NHCP); Atty Lucille Karen Maitlong-Isberto, legal office of the International Council on Monuments and Sites; NCCA Deputy Director Marichu Tellana, signatory of the contract between the NCCA and 401 on December 29, 2016; and members of NCCA’s bids and awards committee from 2015-2016. Rentoria, Maitlong-Isberto, and Barns double as head, vice-head, and member, respectively, of NCCA’s seven-man Technical Working Committee (TWC).
Last January 21, after the board decided to end the budget and services of all architects and engineers of NCCA’s PMT, Almario transferred all documents of the Met project to Escalante, a board member and head of NHCP, an agency attached to NCCA, for a “fruitful collaboration.” It meant taking away the direct management of the Met project from NCCA Executive Director Pableo, a board member who was once on top of NCCA’s TWC and PMT, a source explained. Pableo was appointed NCCA’s second top leader in March 2017.
When asked how he is adjusting to the changing of the guard at the Met project, Pableo says that “it’s topsy-turvy here. I have a challenging post. I feel alone. The memorandum of agreement between the NCCA and the NHCP will be signed soon, following board approval. The NHCP is creating its own PMT. I want my own PMT for check and balance since payment is coming from the NCCA.” When asked about NHCP’s expertise, Pableo says, “The NHCP was in charge of the conservation of 10 old churches in Bohol, central Philippines. Which were destroyed by a 7.2 magnitude earthquake in 2013. The contractor was 401. The NHCP and 401 seem to have sweet memories.”
Design Alterations and Firing of Professional Consultants

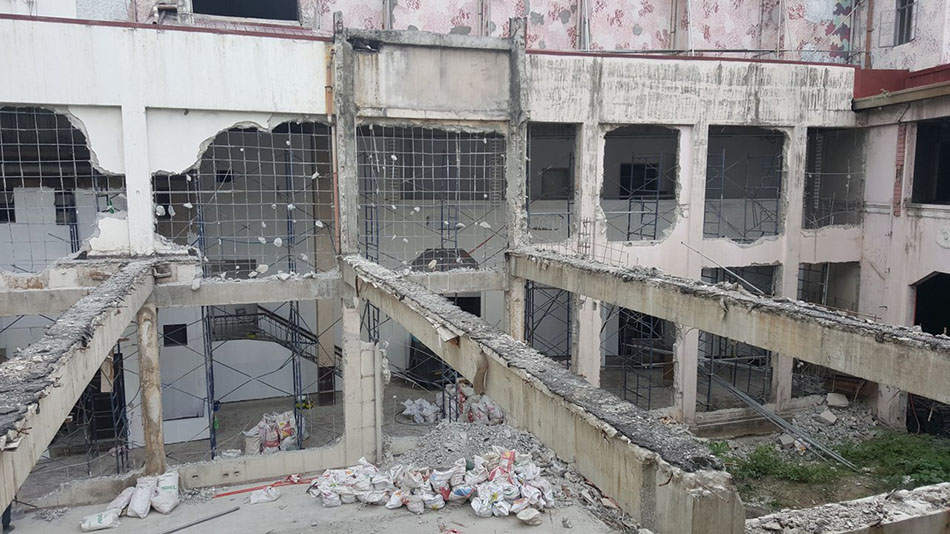

The alterations of Met’s design have resulted in a pattern of firing of architects and engineers. From Nov to Dec 2017, (nine to 10 months after the project started), Barns of the National Museum wanted to demolish the dance and music halls that Mrs. Marcos built at the side of the auditorium in 1978. He wanted to revive the old grand courtyards that architect Arellano established around the auditorium in 1931. At the time, other architects, including Consultant Architect Gerard Lico suggested glass atria on the open gardens to block street noise and heavy downpour during the rainy season. The board approved the proposed alterations in Jan 2018. The dance and music halls were demolished in Nov 2018, 10 months after the proposed changes were approved, and 22 months after the Met project started. In a design done by Consultant Designer Schema Konsult Inc, in late 2016, the two halls were to be transformed into Blackbox Theater and Cinematheque.
In Jan 2018, (11 months after the project started), Barns proposed to place the Met’s air-conditioning system at the back area of the auditorium to widen the courtyard and reclaim its beauty. But Lico and Architect Michael Manalo (of the National Committee on Monuments and Sites (NCMS) insisted it should remain as designed earlier by Schema - at the auditorium’s middle area “for efficiency and long-term maintenance.” Five months later, in June 2018, the NCCA board did not renew the contracts of Lico, including Architect Paolo Josue and Engineer Bjorn Commendador who were PMT members. Commendador was re-hired as PMT member in Aug 2018. Architect Maria Rajelyn Busmente, who requested not to renew her contract in June (in sympathy with Lico and company) was re-hired as project coordinator in September 2018.In November 2018, five months after the ouster of first set of architects and engineer, Barns renewed his preferred place for the Met’s air conditioning system. Pableo advised Barns to write the proposed change, for board approval and contractor’s guidance. In January, 2019, there was no approval and implementation of Barn’s preferred design because of the absence of a written proposal. Then the board decided instead to end the services of professional architects and engineers, effective Feb 15.
Despite the rude roads that could derail the Met project, Pableo vowed, “I will see this project done properly—with good governance and architectural integrity—within the year.” Nostalgic Filipinos are keeping their fingers crossed.
Click on the image below for slideshow

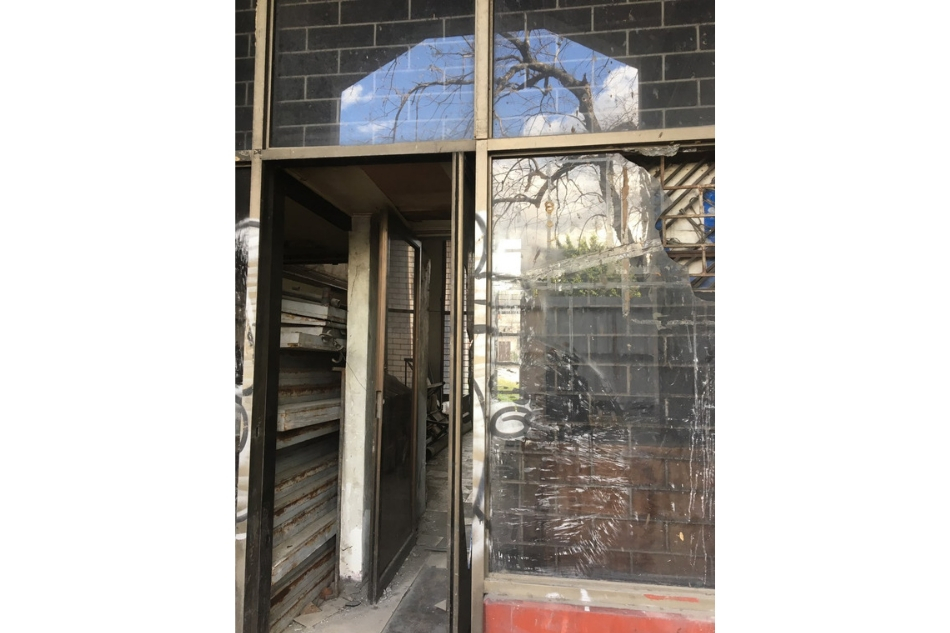

Photos taken by the author during a site visit on February 12, 2019
